You’re standing in a dated bathroom, picturing the new tile and fixtures, and the practical question hits: how long am I going to be without this bathroom? Especially if it’s the only full bathroom in the house, the timeline isn’t just curiosity — it’s logistics.

Here is the straight answer: a standard full bathroom renovation in Abbotsford takes 2 to 4 weeks of construction, with a simple cosmetic refresh coming in at around a week. A small powder room can be quicker. A master ensuite with moved plumbing? Past a month, easily. And construction is only part of the story. Planning comes first. Permits. Material lead times. Those add several more weeks before anyone picks up a hammer.

This guide walks through the realistic phase-by-phase timeline, what actually causes delays (tile curing time is the big one nobody warns you about), how to survive without your main bathroom, and how to keep the whole project on schedule. Let’s get into it.

Disclaimer: Timelines in this guide are realistic planning ranges for Abbotsford and the Fraser Valley, based on standard industry practice and local market conditions. Every bathroom is different — your timeline depends on the scope, your home’s condition, material lead times, and your contractor’s schedule. This guide is for planning purposes, not a project quote.

Bathroom Renovation Timelines at a Glance

Project scopeTypical construction timeWhat it involves
Cosmetic refresh3–7 daysNew paint, vanity, mirror, lighting, fixtures, hardware. No tile work, no plumbing moves.
Standard full gut2–3 weeksDemolition, new plumbing and electrical rough-in, waterproofing, floor and shower tile, new vanity, toilet, and fixtures.
Master ensuite / layout change3–5 weeksEverything above, plus moved plumbing, custom glass, heated floors, or structural changes.

Those are construction days, though. The number that matters for your calendar is bigger. From “we’ve decided to do this” to “we’re showering in the new bathroom” usually runs 6 to 10 weeks. Count in the design decisions. The Abbotsford permit process (2–4 weeks for bathroom renovations). Material ordering. Getting on a contractor’s schedule at all. More on that below.

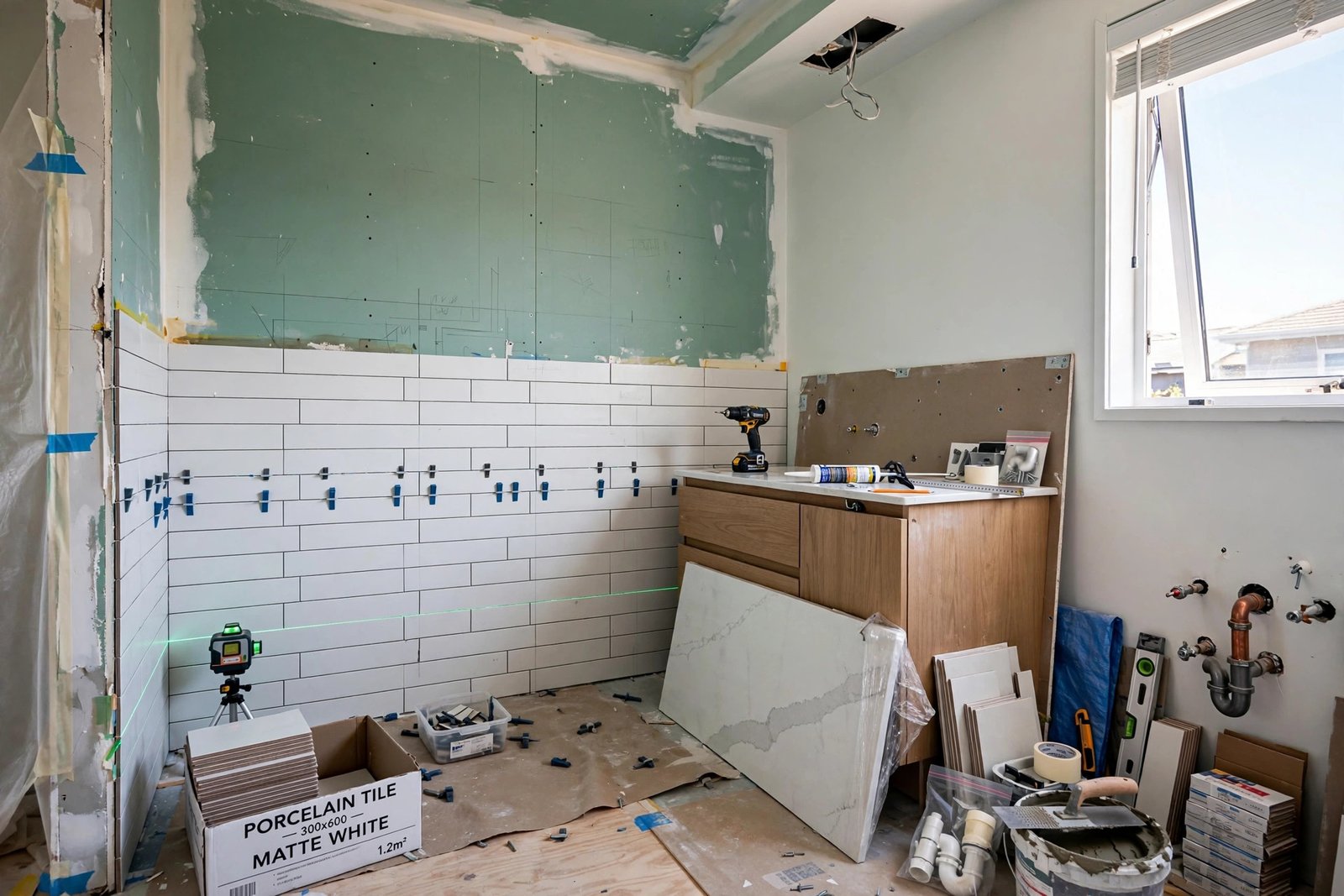

Bathroom mid-renovation with new tile being installed in Abbotsford
Mid-renovation, the timeline is set by the phases you cannot rush — rough-in, waterproofing, and tile curing.

The Phase-by-Phase Breakdown of a Full Bathroom Renovation

Here’s what happens inside those 2–3 weeks, and why each phase takes as long as it does.

Days 1–2: Demolition

Out comes the old vanity. The toilet, the tile, the fixtures — all of it. A standard 5×8 bathroom takes a day or two to gut properly. This is also when surprises surface. And in older Abbotsford homes — there are plenty from the 60s through the 80s — surprises are common. Rotted subfloor around the toilet flange. Galvanized supply lines that crumble when you touch them. Questionable DIY wiring from a previous owner. A good contractor budgets contingency time here. A bad one pretends the surprises don’t exist. Right up until they blow up the schedule.

Days 3–5: Plumbing and electrical rough-in

While the walls are open, in go the new supply lines. Drain locations get set. Shower valve bodies, too, and the electrical — pot lights, a fan, GFCI outlets, heated floor wiring if you’re adding it. Then comes the rough-in inspection — the City of Abbotsford needs to sign off before walls get closed up. The inspection wait can add a day. Two, sometimes. That’s normal. It isn’t a sign of a problem. And don’t rush this phase. Everything behind the walls? The hardest thing in the whole job to fix later. The most expensive, too.

Days 6–12: Waterproofing and tile — the longest phase

Most of the calendar lives here. Impatient timelines fall apart here, too. The sequence runs like this. Cement board — or a waterproof membrane system — goes on the shower walls. Then floor preparation. Then the tile goes in. Then grout. Then cure time, which nobody gets to skip.

Tile setting itself takes 3–5 days for a typical bathroom. Then everything waits. The thinset mortar needs to cure. The grout too — usually 48 to 72 hours before the shower sees water. Longer when it’s cold. Longer when it’s humid. Someone tells you the shower is fine to use the day after grouting? One of two things is going on. Either they used rapid-set products — pricier, and even those need their stated cure time — or steps got skipped. Steps you’ll regret. Rush the waterproofing and you’re buying yourself a $20,000 leak repair two years from now. This phase cannot be compressed by enthusiasm.

Days 13–15: Fixtures and finishes

Vanity installation, toilet set, shower trim and valve handles, towel bars, mirror, lighting fixtures, and paint. This phase moves fast when everything’s on site — which is why ordering materials before demolition matters so much.

Days 16–18: Glass, caulking, and punch list

Nobody measures the frameless glass shower door until the tile is done. It can’t be done before. And custom glass typically needs 1–2 weeks of lead time. That’s why experienced contractors measure early. They schedule the install at the tail end. Or you shower behind a temporary curtain for a week — that happens too. Then the last bits. Final caulking. Paint touch-ups. The punch list — that one crooked towel bar, the grout haze nobody noticed — closes out the job.

Before the First Hammer Swings: The Timeline Nobody Counts

Contractors quote construction time. Homeowners live the total timeline. Here’s what happens before day one:

Add it up and the honest door-to-door timeline for a full bathroom renovation is 6–10 weeks. Plan for it and you’ll be relaxed. Assume “two weeks” and you’ll be frustrated by week three.

What Actually Causes Bathroom Renovation Delays

Ask contractors what derails schedules and you’ll hear the same list:

Finished renovated bathroom in Maple Ridge BC with tiled walk-in shower, floating vanity and modern fixtures
A finished bathroom is worth the wait — the final fixtures and glass only go in after tile and grout have fully cured.

Surviving Without Your Main Bathroom

This is the part that matters most if you have one full bathroom. A few practical strategies:

7 Ways to Keep Your Bathroom Renovation on Schedule

  1. Finalize every selection before demolition. Tile, grout colour, vanity, faucet, mirror, paint — all of it. Decide during construction instead? That’s how 2-week projects turn into 5-week projects.
  2. Confirm all materials are on site or in stock before demo day. If the vanity is backordered, wait. Demolishing first and hoping is how bathrooms sit gutted for a month.
  3. Get the permit submitted early. The 2–4 week Abbotsford permit window should run in parallel with your material ordering, not after it.
  4. Keep the plumbing where it is. Move a toilet and you’ve added days. A shower drain, same thing — more rough-in work, another inspection cycle, real cost on top. The existing layout? Almost always fine as it stands.
  5. Book inspections the moment rough-in is done. Don’t let the job sit waiting — a day lost here cascades through every trade behind it.
  6. Build in buffer days. Add 3–5 contingency days to whatever timeline you’re quoted. If you don’t need them, you’re pleasantly surprised. If you do, you’re still on schedule.
  7. Communicate in writing. Check in daily. Every other day at least. And change requests? In writing, with the time impact spelled out. The cost impact too. Verbal “sure, we can do that” is where timelines go to die.

Bathroom Renovation Timeline FAQs — Abbotsford

How long does a bathroom renovation take?

A cosmetic refresh takes 3–7 days. A standard full gut renovation takes 2–3 weeks of construction. A master ensuite with moved plumbing or custom work takes 3–5 weeks. Including planning, permits (2–4 weeks in Abbotsford), and material lead times, plan for 6–10 weeks door to door.

Can I use my bathroom during the renovation?

Partially. Demolition days? The bathroom is out of commission. Rough-in days, too — fully. Once fixtures start going back in, a good contractor will usually keep the toilet functional overnight. The shower is the last thing to come back online — tile and grout need 48–72 hours of cure time after installation.

How long does bathroom tile need to cure before I can shower?

At least 48–72 hours after grouting for standard thinset and grout, and the manufacturer’s instructions are the final word. The shower pan and waterproofing membrane have their own cure times before tile even goes down. This is the phase most worth waiting out — rushing it risks leaks behind the tile.

Do I need a permit to renovate a bathroom in Abbotsford?

Yes, if the work involves plumbing, electrical, or structural changes — which a full gut almost always does. Cosmetic updates (paint, new vanity, fixtures in the same locations) generally don’t require one. Bathroom renovation permits in Abbotsford take about 2–4 weeks through the City’s Building Department.

Should I buy the materials myself or let the contractor supply them?

Let the contractor supply or at least approve them. Contractors know which products their trades prefer working with, they get trade pricing, and — critically — they’re responsible for the schedule if a product they ordered is delayed. If you supply, confirm exact models and lead times in writing before demo day.

Can a bathroom renovation be done in one week?

A cosmetic refresh, yes. A full gut, no — not properly. Promise you a complete demolition-to-done bathroom in five days? They’re skipping something. Cure times, maybe. Inspections, maybe. Both, probably. The waterproofing alone needs more than a week to do right. Tile too.

How much does a bathroom renovation cost in Abbotsford?

A full bathroom renovation in Abbotsford runs $14,000–$32,000 in 2026, with $20,000 the typical price point. A cosmetic refresh starts around $8,000. See our full bathroom renovation cost guide for Abbotsford for the detailed breakdown.

For the bigger picture, our bathroom renovation in Abbotsford page covers complete bathroom projects, from layout changes and walk-in showers to full gut-and-rebuild work across the Fraser Valley.

Planning a Bathroom Renovation in Abbotsford?

The difference between a smooth bathroom renovation and a stressful one usually isn’t the contractor — it’s the planning. Finalized selections, materials on site before demolition, a permit submitted early, and a realistic 6–10 week door-to-door expectation will get you through the project calmly.

If you’re ready to start, take a look at our bathroom remodeling services in Abbotsford to see what’s included in a full renovation, from demolition and waterproofing to the final fixtures. And if budget is your next question, our bathroom renovation cost guide for Abbotsford breaks down exactly where the money goes.

Reminder: Timelines in this guide are realistic 2026 planning ranges for the Abbotsford and Fraser Valley area, not a project quote. For an accurate schedule for your bathroom, get a written timeline from local contractors based on your specific scope and material selections.
